Same China carpentry order as the feature-wall carpentry cost post — Jishang in Foshan. Vinyl is down, floor protection is sorted, 3PF is Ali (A-li 國際物流). The waiting stretch from the earlier post is over. Goods hit Singapore, last-mile at the EC threw an unforeseen cost, then on 2 Sep everything came into the unit.

From Foshan to Singapore

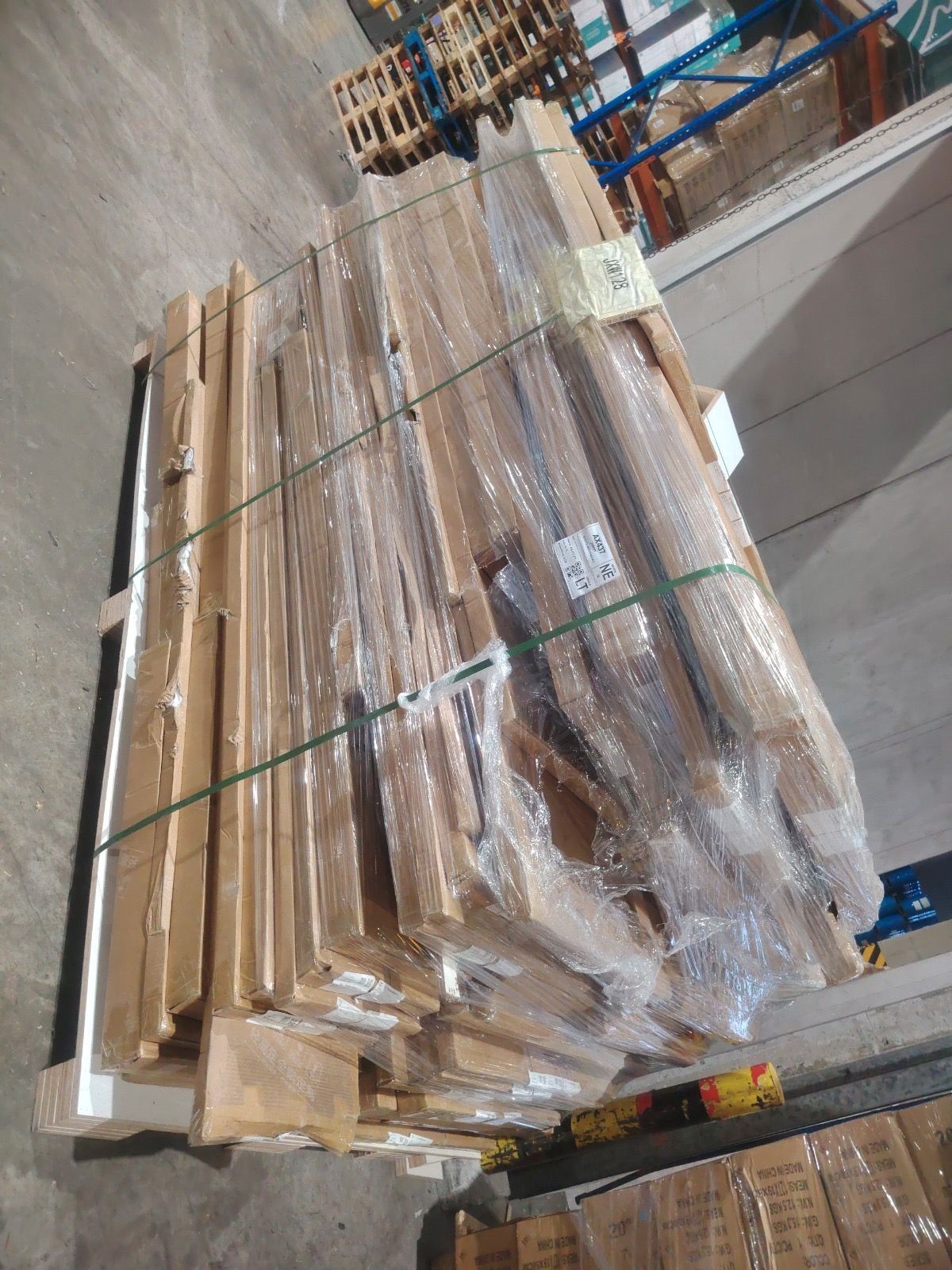

On 17 Aug 2026, Jishang sent the carpentry out from Foshan to my 3PF.

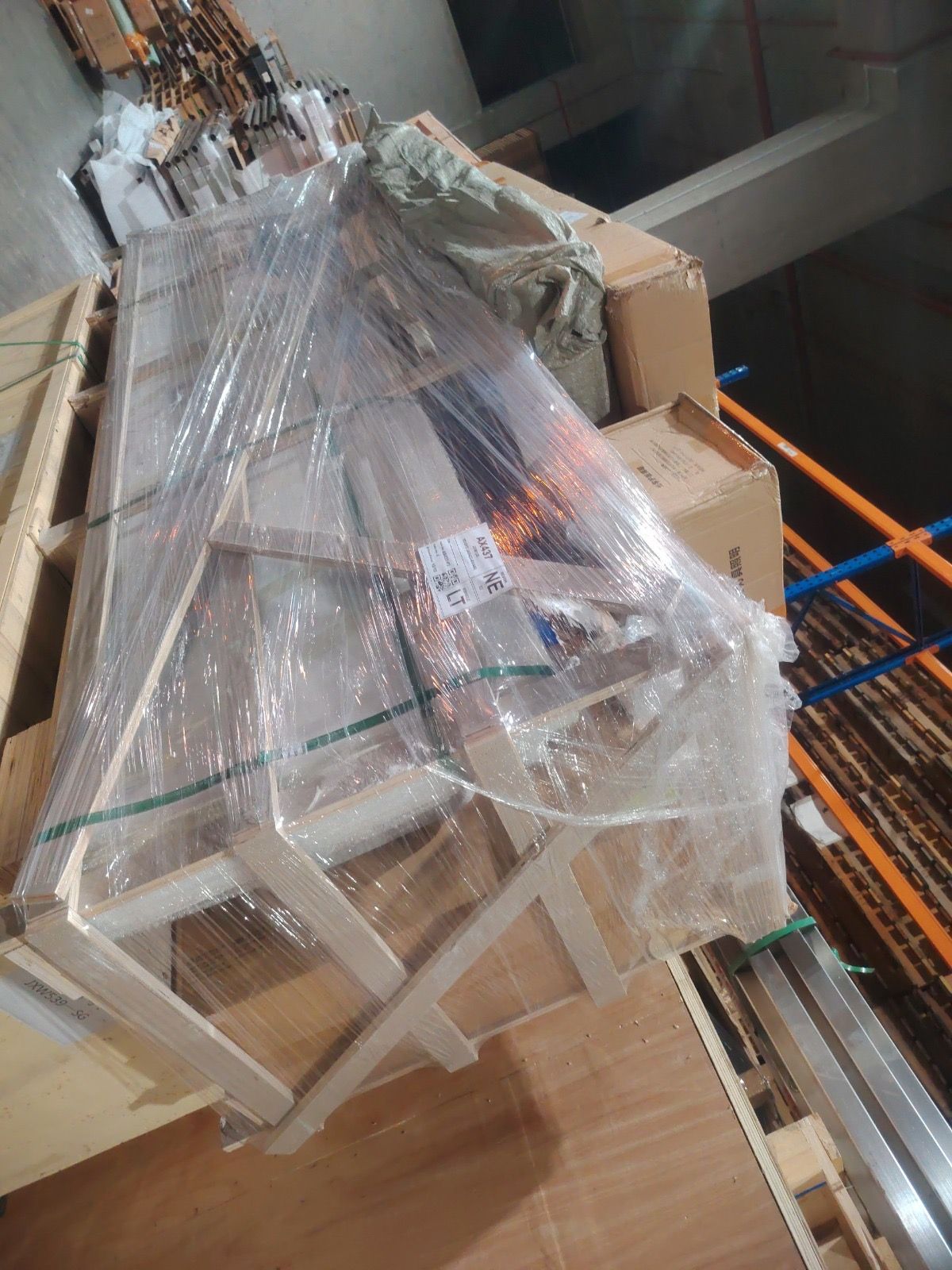

Next day, 18 Aug, it was loaded into a container for sea shipping.
Initially they projected it would reach Singapore on 26 Aug. Then it slipped to 29 Aug.
29 Aug was a Saturday. Most local last-mile delivery do not work Sunday, so nothing was going to move that weekend.
Monday 31 Aug morning, some messages and a call. That is when the EC delivery problem showed up.
Why a huge lorry wouldn't work at an EC
The unit is in an EC. Those are usually strict about vehicle access, so a huge lorry was not going to work.
Doing it that way would mean loading outside and using a trolley to push everything in. Inefficient. Not how they wanted to run it.
Last mile called to say they will unpack the stuff, load it into a van, then the van can drive into the carpark. That was the plan on the call — and the unforeseen cost sat on top of it.

The $600 van reload
Extra cost for that service: $600.
I did not plan for it. Honest miss. When you are budgeting China carpentry, the factory and the sea leg are the bits you stare at. Last-mile at an EC can still throw a number at you.
Take note if you order from China. The situation varies by where it is delivered and how big the items are. An EC with strict access is not the same as somewhere a big lorry can just roll up.

Delivery was set for 2 Sep 2026. When I first wrote this on 1 Sep, that was still tomorrow. It has since happened.
16 days, not a promise
Rough gauge from my case: about 12 days from sending out to reaching Singapore, then another 4 days to arrange delivery. About 16 days end to end for me.
That is a gauge, not a definite timeline for someone else's reno. Sea schedules slip. Weekends sit idle. EC last-mile adds its own steps. Yours will differ.
2 Sep — into the unit

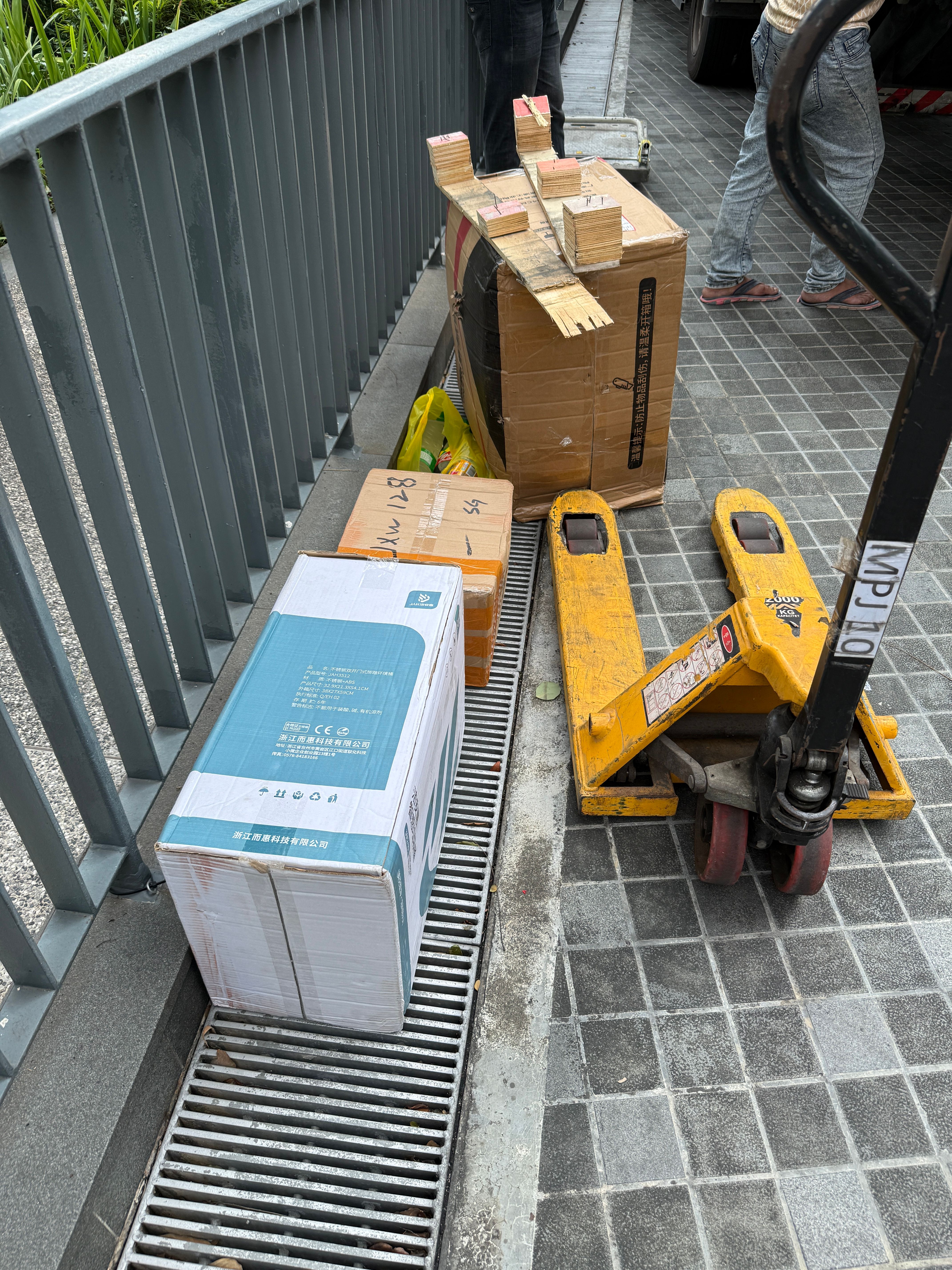

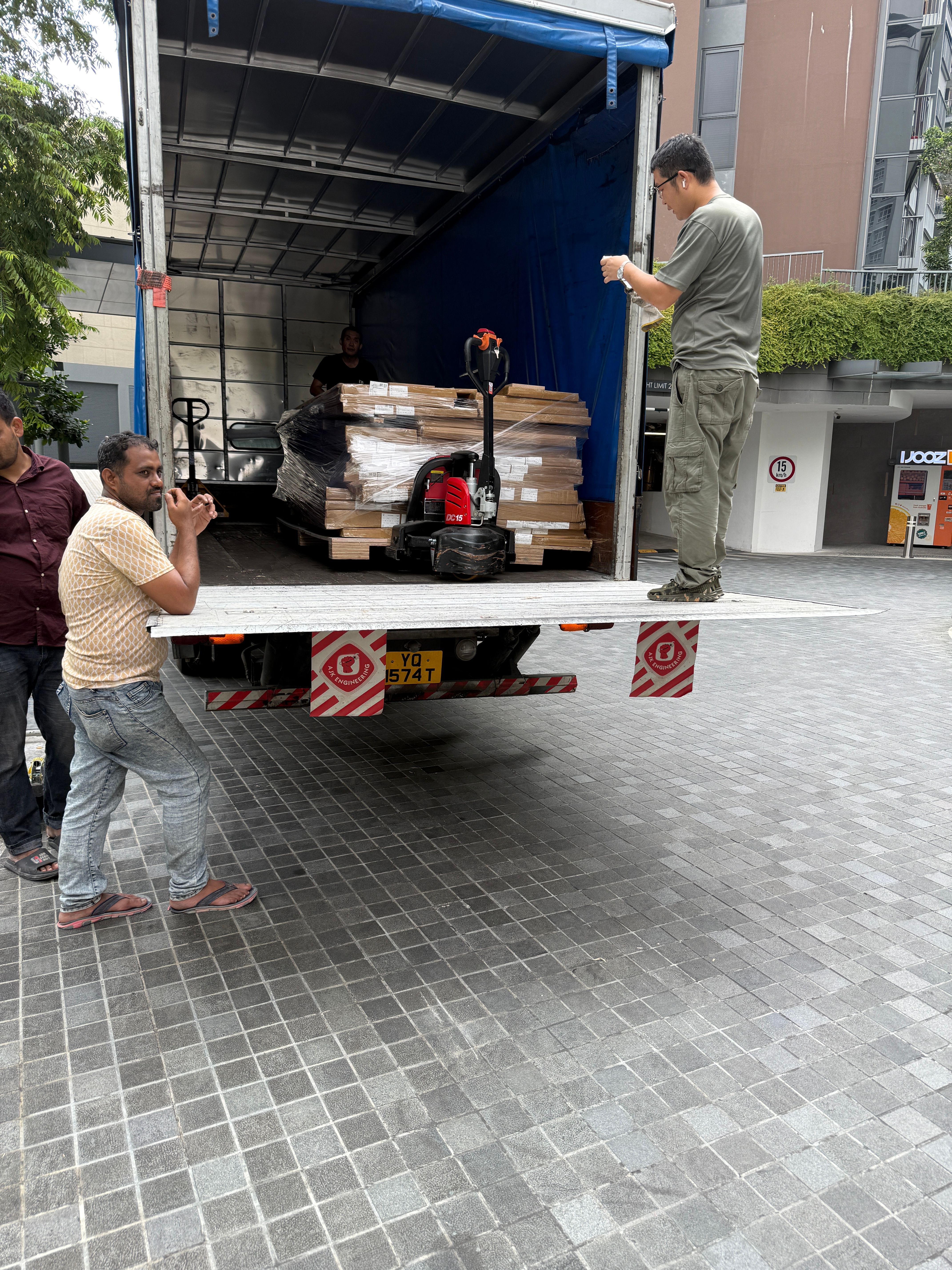

On 2 Sep 2026 they brought it to the EC. Two groups showed up. First, a huge lorry crew unloaded the entire pallet outside the building — roughly 10am to 11am. Then four other guys moved everything from outside into the lift and up to the unit.

No visible damage. I am pleased with the shipping company and the last-mile company. Not naming them here — just noting that this part went clean.

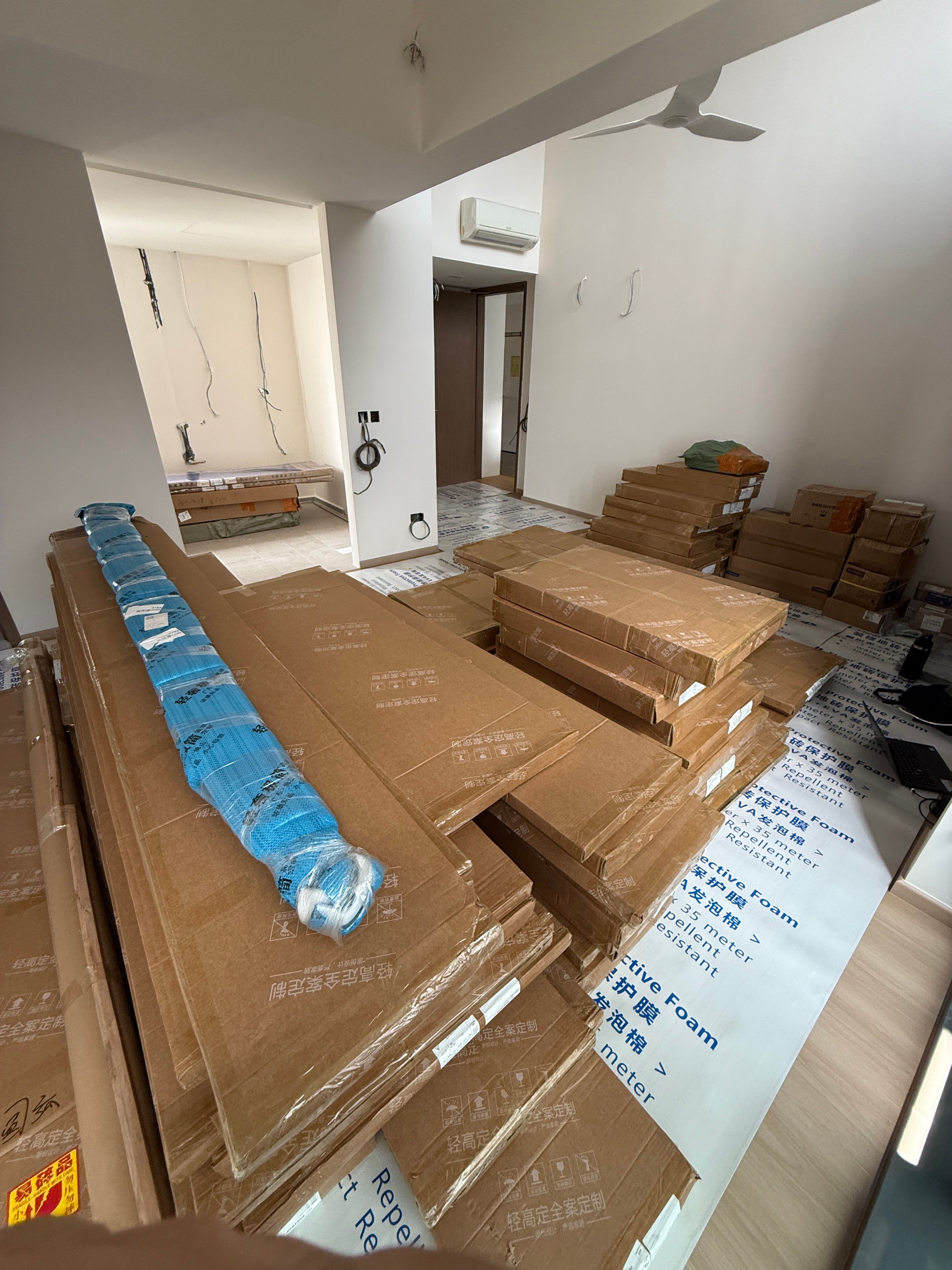

Floor protection foam is down in the unit — same idea as the waiting post. Packages are stacked inside. Installation has not started.




Key pieces that came with it

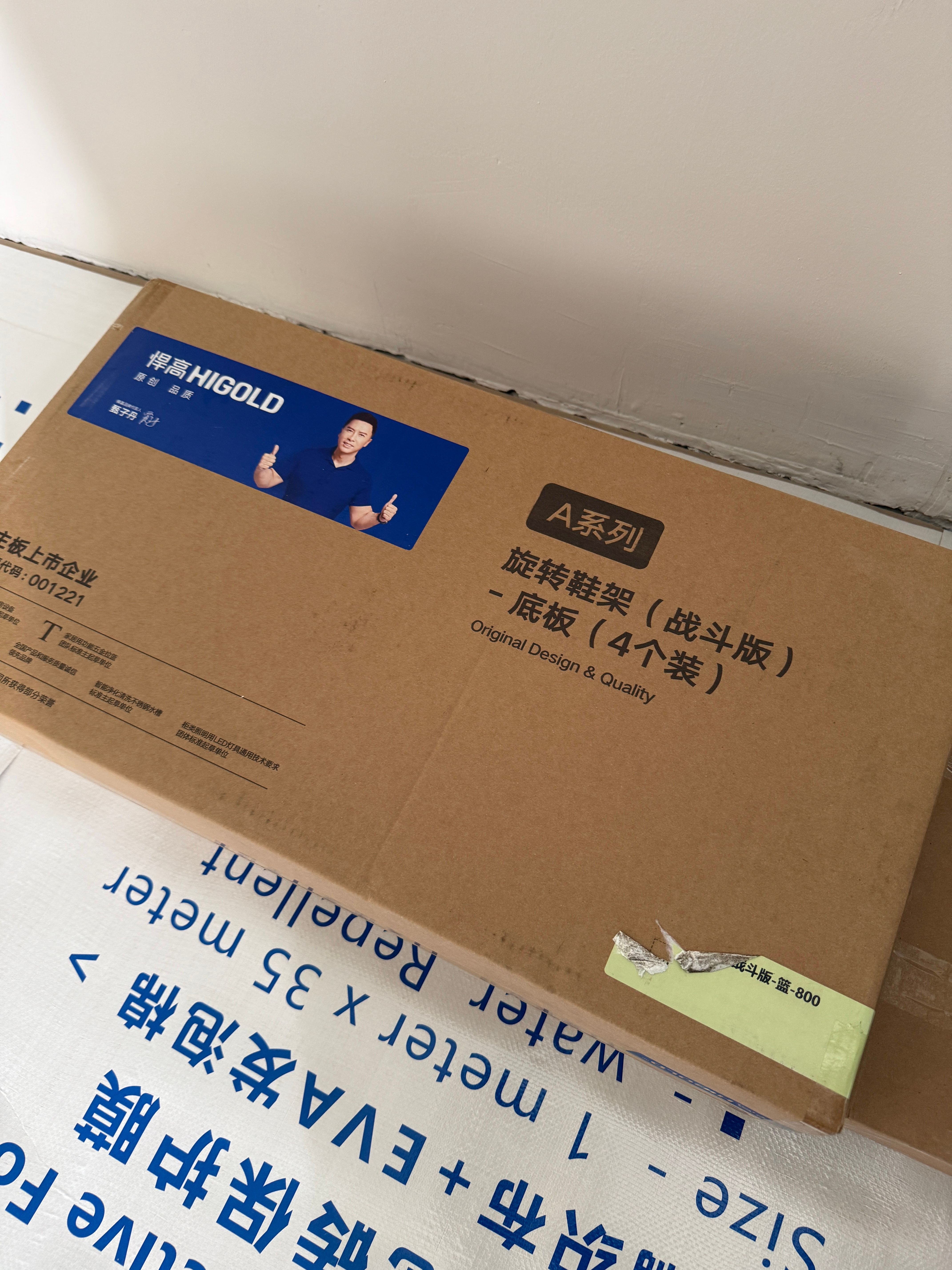

Not just cabinet panels. A few of the bigger kitchen pieces came in the same delivery — the stuff I had already talked through in the recent remodel story.




Update: install has started — Installation Day One.
